PCB assembly lead time plays a critical role in product development, time-to-market, and supply chain planning. Delays in PCBA production can affect testing schedules, product launches, and customer commitments.
In this guide, TOPFAST, a professional PCB manufacturer, explains PCB assembly lead times, what affects turnaround time, and how to shorten delivery without sacrificing quality.
Table of Contents
What Is PCB Assembly Lead Time?
PCB assembly lead time refers to the total time from file approval to finished PCBA shipment.
It typically includes:
- Engineering review and file verification
- PCB fabrication
- Component sourcing
- SMT & THT assembly
- Testing and quality control
- Packaging and delivery
Process overview:

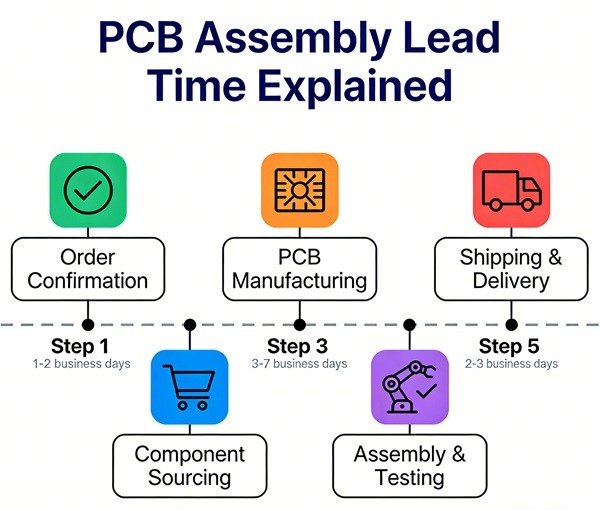

PCB Assembly Process Explained
Typical PCB Assembly Lead Times
Prototype PCB Assembly
| Stage | Typical Time |
|---|---|
| File review & DFM | 1–2 days |
| PCB fabrication | 2–4 days |
| Component sourcing | 1–3 days |
| Assembly & soldering | 1–2 days |
| Testing & QC | 1 day |
Total prototype lead time:
3–7 working days (fast-track options available)
Low to Medium Volume Production
- PCB fabrication: 5–7 days
- Component sourcing: 3–7 days
- Assembly & testing: 3–5 days
Total lead time:
10–15 working days
Mass Production PCB Assembly
- PCB fabrication: 7–12 days
- Component sourcing: 1–3 weeks
- Assembly & testing: 5–10 days
Total lead time:
2–4 weeks, depending on complexity

Key Factors That Affect PCB Assembly Lead Time
1. PCB Complexity
- High layer count
- Fine pitch or HDI design
- Special materials
Related article:
PCB Manufacturing vs PCB Assembly
2. Component Availability
Component sourcing is often the biggest bottleneck.
Delays occur due to:
- Long lead-time components
- Obsolete or EOL parts
- Single-source components
File preparation matters:
PCB Assembly File Requirements Explained
3. Assembly Method (SMT vs THT)
- SMT assembly is faster and more automated
- THT assembly increases manual labor
- Mixed assembly adds complexity
Related guide:
SMT vs THT PCB Assembly: Key Differences Explained
4. Testing Requirements
- AOI only → fastest
- X-ray, ICT, FCT → longer lead time
- Custom fixtures add setup time
Related article:
PCBA Testing Methods Explained
5. Turnkey vs Consigned Assembly
- Turnkey PCBA: Faster coordination
- Consigned PCBA: Risk of missing or late components
Related guide:
What Is Turnkey PCB Assembly and How It Works
How to Reduce PCB Assembly Lead Time
Submit Complete and Accurate Files
- Gerber, BOM, Pick-and-Place
- Assembly notes and alternatives
Checklist:
PCB Assembly File Requirements Explained
Use Alternative Components
- Approve substitutes in advance
- Avoid single-source parts
Choose Turnkey PCB Assembly
- One supplier manages the full process
- Faster communication and sourcing
Service page:
PCB Assembly Services – Complete Turnkey PCBA Solutions
Plan Production Early
- Align prototype and production schedules
- Avoid last-minute changes
Fast Turn PCB Assembly Options
Fast-turn PCB assembly is ideal for:
- Prototypes
- Engineering validation
- Urgent product launches
TOPFAST offers expedited PCBA services with controlled risk and quality assurance.
Lead Time vs Cost Trade-Off
Shorter lead times may:
- Increase component cost
- Require overtime production
- Reduce sourcing flexibility
Cost considerations:
PCB Assembly Cost Explained
Balancing speed and cost is essential.

Industries Sensitive to PCB Assembly Lead Time
- Consumer electronics
- IoT and smart devices
- Automotive electronics
- Medical devices
- Industrial automation
Fast and predictable lead times provide a competitive advantage.
Why Choose TOPFAST for Fast PCB Assembly?
As a professional PCB manufacturer, TOPFAST provides:
- Rapid DFM/DFA review
- Stable component supply chain
- Advanced SMT & THT lines
- Integrated testing and QC
- Reliable global delivery
TOPFAST helps customers shorten time-to-market safely.
Conclusion
Understanding PCB assembly lead time is crucial for planning, budgeting, and ensuring on-time product launches. Factors such as PCB complexity, component availability, assembly method, and testing requirements all influence turnaround time. By preparing accurate files, selecting turnkey PCB assembly, and working with an experienced manufacturer like TOPFAST, customers can significantly reduce delays, maintain high quality, and accelerate time-to-market. Whether for prototypes or mass production, proper planning and a reliable PCBA partner ensure a smooth and predictable assembly process.
PCB Assembly Lead Time FAQ
A: Prototype orders can be completed in as little as 3–5 days.
A: Component shortages and incomplete files.
A: Not when managed by an experienced manufacturer.
A: Yes, after file review and component confirmation.
